The civil works phase of a photovoltaic plant is neither an electrical installation nor a conventional building project. It is a civil engineering undertaking that encompasses earthworks, specialist foundations, access roads and a full range of work that determines — before a single panel is placed — whether a solar park will be profitable and durable.
Understanding what phases it involves and how to manage them correctly is essential for any solar energy developer or project promoter who needs to guarantee timelines, costs and quality in execution.
What solar farm civil works actually cover
Photovoltaic civil works encompass all ground preparation and infrastructure construction that must be completed before the electrical installer places the modules and carries out the wiring.
It must not be confused with the photovoltaic installation itself. The civil works contractor builds what sits beneath and around the panels; the electrical installer connects what goes on top.
Civil works represent between 25 and 35% of the total execution cost of a medium-scale photovoltaic plant. It is the chapter that most directly determines the critical path and overall project schedule.
The work packages that form part of photovoltaic civil works are:
- Geotechnical study and topographic survey prior to the start of construction
- Earthworks, site clearance and grading of the platform
- Foundations for the panel support structures: pile driving or concrete footing depending on ground conditions
- Interior access roads for construction and long-term maintenance
- Underground conduit systems for medium-voltage electrical cabling
- Perimeter fencing and access control infrastructure
- Auxiliary buildings: inverter rooms, substations and transformer centres
Phases of photovoltaic civil works
The phase sequence is not interchangeable. Each stage conditions the next, and any deviation in the preliminary studies multiplies in cost and time throughout the subsequent phases.
1. Preliminary studies: geotechnical survey and topography
The geotechnical study determines the bearing capacity of the soil and defines the most appropriate foundation type: steel pile driving or conventional concrete footings. The topographic survey defines grading profiles and the layout of interior access roads.
Cutting corners on this step is the most expensive mistake a developer can make. An inadequate geotechnical survey invalidates the foundation solution specified in the project and forces a redesign once works have already begun.

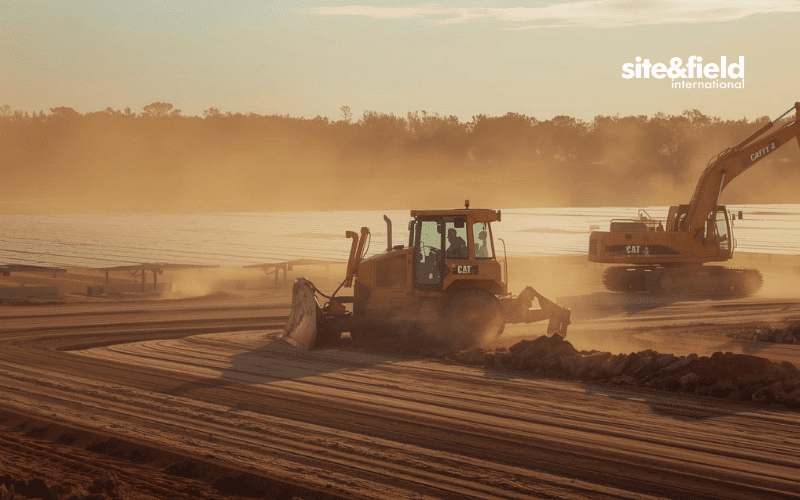

2. Earthworks and platform grading
This phase covers vegetation removal, site clearance, cut-and-fill earthworks and compaction of the platform. On plants exceeding 10 MW, this chapter can involve months of heavy machinery operating in parallel.
Critical point: the residual slope after grading must be compatible with the inclination of the fixed or tracking support structures. A poorly levelled terrain forces a full revision of the park layout and can invalidate the row distribution set out in the executive project.
3. Foundations: pile driving vs conventional concrete footings
The choice between driven pile foundations and conventional concrete footings depends on the geotechnical study results. In Spain, steel pile driving is the dominant solution due to its speed of execution and minimal ground impact.
A 50 MW plant can require between 40,000 and 80,000 driven piles depending on the structural pitch. The daily output of a pile driver with a specialist crew can exceed 500 piles per shift in favourable ground conditions. Having civil works for photovoltaic plants executed with owned machinery is a real differentiator in timelines and cost compared with subcontracting that equipment.

4. Interior roads and electrical conduits
Interior roads are not solely a construction access route: they dimension the operational maintenance capacity of the park over its 25-30 year lifespan. A poorly designed road prevents cleaning trucks or cranes from accessing the site for equipment replacement.
Medium-voltage conduit trenches are executed in parallel with pile driving wherever the layout allows, to avoid duplicating the movement of heavy machinery across the same areas. Team coordination during this phase is critical for the overall schedule.
5. Perimeter fencing, auxiliary buildings and site finishing
The perimeter enclosure includes anti-intrusion fencing, approved access gates and statutory signage. Inverter rooms and transformer centres are founded on concrete slabs and require the medium-voltage connections completed in the previous phase.
The close-out of civil works coincides with the handover of the site to the electromechanical assembly team. As-built documentation, final signage and site clearance are prerequisites to that handover in any well-managed project.
At international construction company Site and Field, we execute the full civil works scope of photovoltaic plants with owned machinery — including pile drivers — for projects across Spain, the United Kingdom, the UAE and Denmark.
Realistic timelines for photovoltaic civil works
Timelines depend on three variables: the installed capacity of the plant, ground conditions and the volume of deployed machinery. As an indicative reference:
- Plants up to 10 MW: complete civil works in 3-5 months with a standard crew
- Plants from 10 to 50 MW: 5-9 months with parallel pile driving and earthworks teams
- Plants above 50 MW: 9-18 months; typically executed in simultaneous construction lots to compress the overall programme
According to International Energy Agency data, global solar capacity additions have broken records in recent years, generating sustained demand for civil contractors with the ability to scale crews and machinery rapidly.
Frequent limiting factor: the availability of pile driving equipment approved for the project’s technical specifications. Supply chain delays for machinery are one of the main schedule risks on projects awarded to contractors without an owned fleet.

What to require from your photovoltaic EPC civil works contractor
A civil EPC contractor is not the same profile as a general photovoltaic installer. Before awarding the contract, assess at least the following criteria:
- Owned machinery, especially pile drivers: a subcontractor that rents equipment cannot control schedules when sector demand peaks
- Proven track record on operating plants: request references for comparable projects in MW and ground type
- Quality certifications: ISO 9001, ISO 14001 and ISO 45001 are the minimum for projects involving institutional lenders
- Interface coordination with the electrical installer: civil/electromechanical interface disputes are the most frequent source of cost overruns on solar parks
- International capacity: for projects outside Spain, the contractor’s local subsidiaries reduce regulatory and logistical risk significantly
The complete construction process of a photovoltaic solar farm involves coordinating multiple contracts; civil works is the chapter with the greatest impact on the overall critical path.
For a broader understanding of sector context and incentive frameworks, the Institute for Energy Diversification and Saving (IDAE) and UNEF — Spain’s photovoltaic industry association publish regularly updated data on renewable deployment in Spain.
Choosing a contractor with EPC experience in civil works and infrastructure, owned machinery and international subsidiaries eliminates the three main timeline and cost risks that repeatedly materialise on this type of project.
Frequently Asked Questions
What does the civil works scope of a photovoltaic plant include?
The civil works scope of a photovoltaic plant includes geotechnical study and topographic survey, earthworks and platform grading, foundations for the panel support structures (pile driving or concrete footings), interior access road construction, underground conduit systems for medium-voltage cabling, perimeter fencing and the construction of auxiliary buildings such as inverter rooms and transformer centres.
How long do photovoltaic civil works take?
The execution timeline depends on the plant’s installed capacity and ground conditions. As a reference: plants up to 10 MW require 3 to 5 months; plants from 10 to 50 MW require 5 to 9 months; plants above 50 MW can exceed 12-18 months when executed in sequential lots.
What is an EPC contractor in solar energy?
An EPC (Engineering, Procurement and Construction) contractor in solar energy is the company responsible for engineering, material procurement and construction of the plant or a defined portion of it. In the context of photovoltaic civil EPC, the scope covers ground preparation, foundations, access roads and auxiliary buildings, excluding the electrical installation and photovoltaic modules.
What is the difference between driven pile foundations and conventional concrete footings in solar plants?
Driven pile foundations involve pressing steel posts directly into the ground using specialist machinery, with no concrete required. They are faster, more economical and have a lower environmental footprint than conventional concrete footings. Conventional footings are used when the geotechnical study determines that the soil does not have sufficient bearing capacity for pile driving.
Why is it important to subcontract photovoltaic civil works to a specialist?
Photovoltaic civil works require specialist machinery, sector-specific regulatory knowledge and precise coordination with the other project contracts. A general contractor without solar park experience can compromise the critical path schedule, create interface incompatibilities with the electromechanical assembly and generate cost overruns that are difficult to recover once works are advanced.
